An operational example based on marineM's supported capabilities. This is a representative planning situation, not a named customer case or a measured before-and-after result.
A berth becomes available later than expected. Another berth may be free sooner, but moving the vessel there changes the services needed to support the arrival. The berth planner can see the space. The marine team must establish whether the people, tugs and supporting resources can deliver the movement at the proposed time.
For a Harbour Master, these are parts of the same decision. A berth window is useful only if the vessel can reach it with the required services and within the relevant operating constraints.

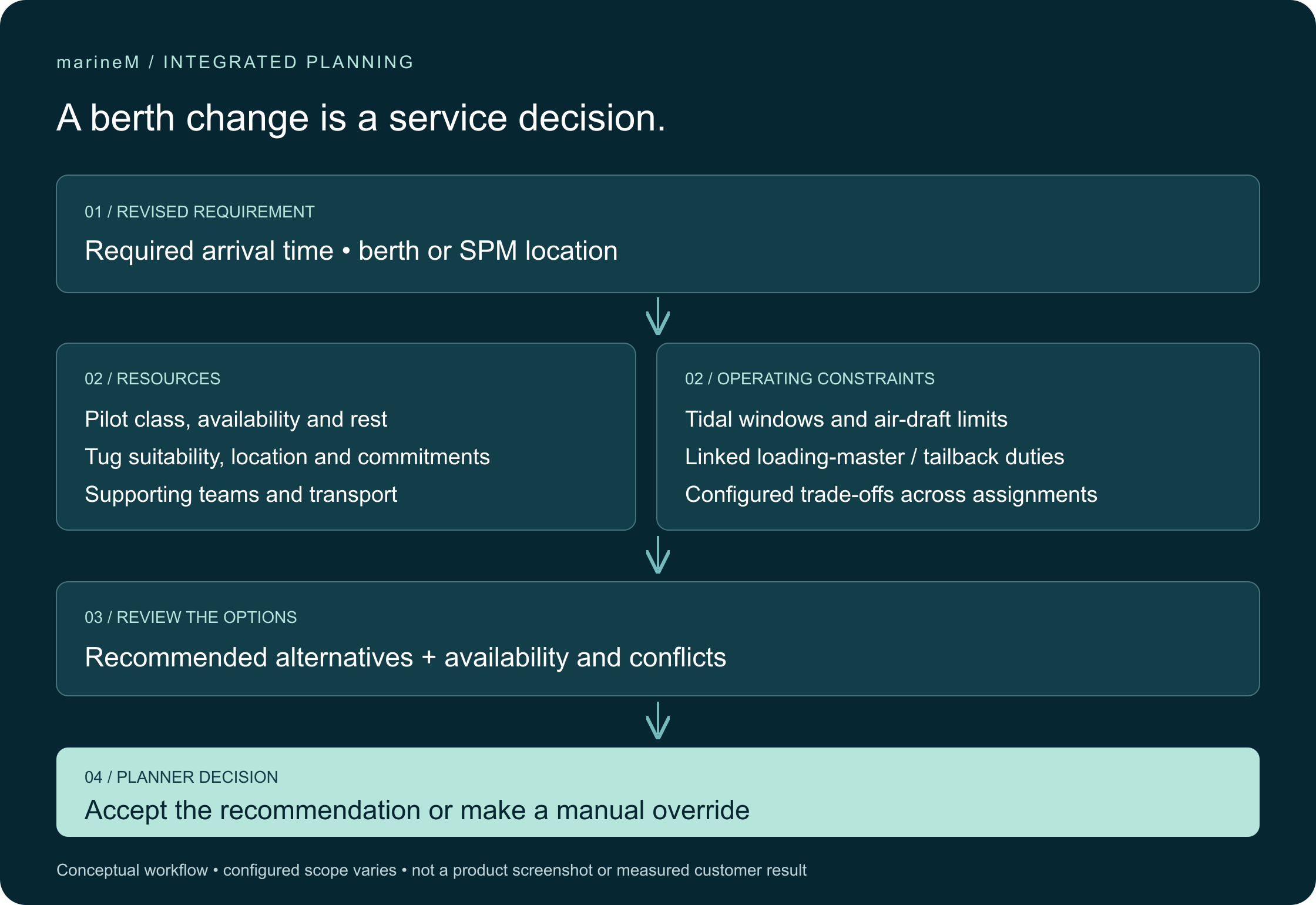

marineM connects Berth Planner with Marine Services Planner so the team can consider berth timing and nautical service availability together. The system can recommend feasible alternative movement times and show availability and conflicts. Planners can accept the recommendations or make manual overrides.

Start with the required arrival
Marine Services Planner generates assignment plans around the time a vessel needs to be at the jetty or Single Point Mooring (SPM). That means looking beyond a vacant berth or a single free resource.
The operation may require a pilot with the appropriate licence and class for the vessel, suitable tugs, pilot transport, a mooring team and line boats. A pilot's availability also depends on rest requirements. A tug must meet the applicable bollard-pull requirement and be able to reach the assignment in time.
When the berth location or ETA changes, those dependencies need to be considered again. A resource that suited the original movement may not fit the revised one.
Test the change against the whole operation
In this example, a planner considers moving the arrival to another berth. The berth itself is available, but one pilot cannot take the movement within the configured rest requirements, and a suitable nearby tug is committed elsewhere.
The useful question is now specific: which movement times can the available resources support, taking the relevant tidal constraints and air-draft limits into account?
marineM can recommend feasible alternatives while showing the planner the availability and conflicts behind the decision. Where configured trade-offs allow it, the assignment plan can consider a suitable tug from farther away. Its location and travel requirement matter alongside its bollard pull and other commitments.
A feasible option might require a different movement time or resource allocation. The planner reviews the recommendations and decides what to accept or override. The system supports that decision; it does not replace the port's operational authority.
Plan the commitments after the arrival
SPM operations add another layer because the resources supporting the approach may also be needed during cargo operations.
Marine Services Planner supports scheduling loading masters, riggers and tailback boats as part of the configured SPM operation. Where pilots are qualified to act as loading masters, their navigation and cargo duties need to be planned together. One supported configuration uses two people rotating through loading-master duties while accounting for the pilot's vessel-class eligibility and sufficient rest.
Tugs also have linked commitments. A tug assigned to navigation may subsequently be needed as the tailback tug supporting the SPM operation. Treating it as free immediately after the approach would miss that later requirement.
When several SPM operations run concurrently, assignments across locations must account for these commitments. Sharing a suitable tug between successive tasks can be considered where timing, location and operating requirements permit. That is different from assigning the same resource to overlapping duties.
These examples illustrate why the complete sequence matters. Planning the arrival without considering the next role can produce an allocation that looks workable for one task but does not support the rest of the operation.
Keep the planner in control
The recommendations and the operational view serve different purposes. Recommendations help the team find workable assignments and movement times. Visibility of availability and conflicts helps the planner assess the choices.
Both are part of marineM's approach. The planner can use the proposed assignment or make a manual override, bringing local operational judgement into the decision.
The scope should reflect what the organisation manages. A port may need berth planning only, marine services planning only, or both. marineM has been implemented in each of these configurations, as well as within wider PMIS implementations connecting orders, planning, execution and finance.
The platform also supports ship-to-ship transfer operations and clients across energy ports, container ports, general cargo ports and ferry terminals. The resources and constraints for each operation need their own configuration; the SPM example is not a template for every port or transfer.
Make adoption part of the implementation
Replacing fragmented systems changes the way people work together. It can affect planners, frontline teams and finance, as well as customers, agents and suppliers.
Innovez One's implementation experience includes a two-phase rollout supported by operational training workshops, local champions and active assistance during the transition. Workshops can focus on how the operation will be managed in marineM, giving people a practical way to understand their role in the new workflow.
The appropriate rollout and support arrangements depend on the project's scope. For a wider PMIS implementation, the connections between ordering, planning, execution and finance deserve attention alongside the planning engine itself.
Demonstrate the decision, then measure the outcome
The immediate capability is concrete: the planner can assess a berth change alongside the services and operating conditions needed to carry it out.
Shorter turnaround, more calls handled, lower tug fuel costs and greater pilot productivity are relevant business objectives. The improvement achieved at a particular port needs evidence. Where comparable pre-implementation data is unavailable, current operational records should be used to establish a baseline for future assessment rather than presented as proof of a historic reduction.
A useful demonstration starts with the port's own challenge. Bring a sample vessel schedule, the relevant berths and constraints, and pilot and tug availability where marine services are in scope. Then examine how marineM handles a change in berth location or arrival time, the alternatives it recommends and the decisions left to the planner.
If pilotage is part of your scope, use our pilot planning and dispatch evaluation checklist to test suitability, transfers and job handovers.
Request a marineM demonstration around your port's planning challenge.
